NMS-Q7-EVM V1.1 ds-en


Introduction

All connections with the external world come through this motherboard, which provide also the required voltage to modules, deriving it from its power supply source.

This board implement the routing of the interface signals Qseven module to external standard connectors.

Technical Specifications

Таблица 1: Main technical specifications
Video Interfaces HDMI interface
Video Resolutions HDMI resolution up to 4k@60Hz
Mass Storage 1 x S-ATA channel (M.2 connector)
USB - 3 x USB 3.0
- 1 x USB 2.0
- 1 x mini USB (USB to UART console)
Networking - Gigabit Ethernet interface (from Q7 SOM Ethernet PHY)
- Gigabit Ethernet interface (from onboard Intel WGI210ITSLJX PCIe Gigabit Ethernet PHY)
Audio - Audio 3.5 mm jack (Line in\Mic in)
- Audio 3.5 mm jack (Line out\Headphones)
PCI Express 2 x PCI-e 1x:
- one routed to M.2 Connector
- one routed to Intel WGI210ITSLJX PCIe Gigabit Ethernet PHY
Serial Ports 1 x Serial port (RS-232/RS-485/RS-422)
1 x Debug console (UART to USB)
Other Interfaces - 1 x CAN interface
- 2 x I2C interface
- 1 x SPI interface
- 1 x LPC interface (8 GPIO)
Power supply voltage +12 VDC
Power consumption TBD
Operating temperature -40°C…+85°C
Dimensions: 147 x 101.60 mm

Electrical Specifications

For correct operation this board need external +12VDC power supply.

Input Voltage: 12V.

All remaining voltages needed for board’s working are generated internally from +12VDC power rail.


Block Diagram

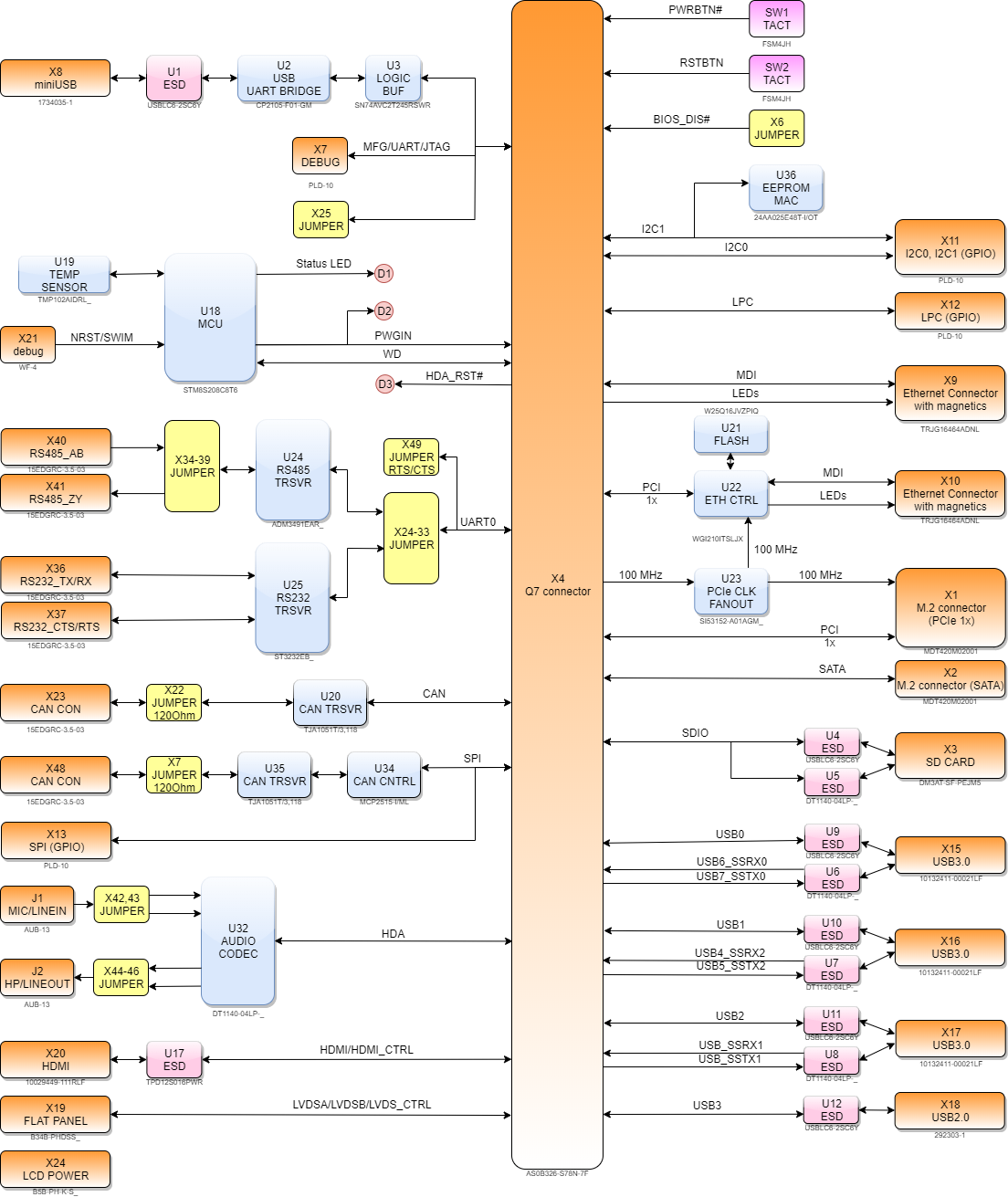

Рисунок 1: Q7Base block diagram


Power tree

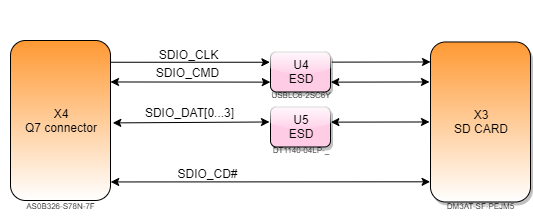

Рисунок 2: Q7Base power tree


Mechanical Specifications

Board dimensions are: 147 x 101.60 mm.

Printed circuit of the board is made of 6 layers, some of them are ground planes, for disturbance rejection.

Рисунок 3: Q7Base mechanical dimensions


Connectors

Introduction

Over current protection, power supply filtering and ESD protection is provided.

Connector Locations

Top View

Рисунок 4: Q7Base top components view


Bottom View

Рисунок 5: Q7Base bot components view


Connectors description

Power in connector

Таблица 2: Power connector
Function Power
Location X5
P/N 0039281043 Molex
Pinout Pin Description
1 GND
2 GND
3 12VIN
4 12VIN

Qseven® Connector

Таблица 3: Qseven connector
Function Qseven Gen 2.0 Connector
Location X4
P/N AS0B326-S78N-7F MFG FOXCONN
Pinout see the table below
Таблица 4: Qseven connector pinout
Pins Name

(Bottom side row)
Signal
group
Type Comments Pins Name

(Top side row)
Signal
group
Type Comments
1 GND PWR 2 GND PWR
3 GBE_MDI3- GBE IO 4 GBE_MDI2- GBE IO
5 GBE_MDI3+ GBE IO 6 GBE_MDI2+ GBE IO
7 GBE_LINK100# GBE I NC 8 GBE_LINK1000# GBE I NC
9 GBE_MDI1- GBE IO 10 GBE_MDI0- GBE IO
11 GBE_MDI1+ GBE IO 12 GBE_MDI0+ GBE IO
13 GBE_LINK# GBE I 14 GBE_ACT# GBE I
15 GBE_CTREF GBE I NC 16 SUS_S5# PWR_MGMT I NC
17 WAKE# PWR_MGMT O PU 18 SUS_S3# PWR_MGMT I NC
19 GPO0(SUS_STAT#) PWR_MGMT I 20 PWRBTN# PWR_MGMT O PU
21 SLP_BTN#/GPII1 PWR_MGMT O PU 22 LID_BTN#/GPII0 PWR_MGMT O PU
23 GND PWR 24 GND PWR
KEY KEY
25 GND PWR 26 PWGIN PWR_MGMT O PD
27 BATLOW#/GPII2 PWR_MGMT O PU 28 RSTBTN# PWR_MGMT O PU
29 SATA0_TX+ SATA I 30 SATA1_TX+ SATA I NC
31 SATA0_TX- SATA I 32 SATA1_TX- SATA I NC
33 SATA_ACT# SATA I NC 34 GND PWR
35 SATA0_RX+ SATA O 36 SATA1_RX+ SATA O NC
37 SATA0_RX- SATA O 38 SATA1_RX- SATA O NC
39 GND PWR 40 GND PWR
41 BIOS_DIS#/BOOT_ALT# BOOT O PU 42 SDIO_CLK# SDIO I
43 SDIO_CD# SDIO IO 44 reserved (SDIO_LED)
45 SDIO_CMD SDIO IO 46 SDIO_WP SDIO IO PD
47 SDIO_PWR# SDIO I NC 48 SDIO_DAT1 SDIO IO
49 SDIO_DAT0 SDIO IO 50 SDIO_DAT3 SDIO IO
51 SDIO_DAT2 SDIO IO 52 reserved (SDIO_DAT5)
53 reserved (SDIO_DAT4) 54 reserved (SDIO_DAT7)
55 reserved (SDIO_DAT6) 56 USB_OTG_PEN (RSVD) USB I NC
57 GND PWR 58 GND PWR
59 HDA_SYNC/I2S_WS AUDIO I 60 SMB_CLK/GP1_I2C_CLK MISC IO
61 HDA_RST#/I2S_RST# AUDIO I 62 SMB_DAT/GP1_I2C_DAT MISC IO
63 HDA_BITCLK/I2S_CLK AUDIO I 64 SMB_ALERT# MISC IO
65 HDA_SDI/I2S_SDI AUDIO O 66 GP0_I2C_CLK (I2C_CLK) MISC IO
67 HDA_SDO/I2S_SDO AUDIO I 68 GP0_I2C_DAT (I2C_DAT) MISC IO
69 THRM# MISC O PU 70 WDTRIG# MISC O PU
71 THRMTRIP# MISC I 72 WDOUT MISC I
73 GND PWR 74 GND PWR
75 USB_P7-/USB_SSTX0- USB IO 76 USB_P6-/USB_SSRX0- USB IO
77 USB_P7+/USB_SSTX0+ USB IO 78 USB_P6+/USB_SSRX0+ USB IO
79 USB_6_7_OC# USB O 80 USB_4_5_OC# USB O
81 USB_P5-/USB_SSTX2- USB IO 82 USB_P4-/USB_SSRX2- USB IO
83 USB_P5+/USB_SSTX2+ USB IO 84 USB_P4+/USB_SSRX2+ USB IO
85 USB_2_3_OC# USB O 86 USB_0_1_OC# USB O
87 USB_P3- USB IO 88 USB_P2- USB IO
89 USB_P3+ USB IO 90 USB_P2+ USB IO
91 USB_VBUS (USB_CC) USB O PU 92 USB_ID USB O PD
93 USB_P1- USB IO 94 USB_P0- USB IO
95 USB_P1+ USB IO 96 USB_P0+ USB IO
97 GND PWR 98 GND PWR
99 eDP0_TX0+/LVDS_A0+ LVDS/eDP I 100 eDP1_TX0+/LVDS_B0+ LVDS/eDP I
101 eDP0_TX0-/LVDS_A0- LVDS/eDP I 102 eDP1_TX0-/LVDS_B0- LVDS/eDP I
103 eDP0_TX1+/LVDS_A1+ LVDS/eDP I 104 eDP1_TX1+/LVDS_B1+ LVDS/eDP I
105 eDP0_TX1-/LVDS_A1- LVDS/eDP I 106 eDP1_TX1-/LVDS_B1- LVDS/eDP I
107 eDP0_TX2+/LVDS_A2+ LVDS/eDP I 108 eDP1_TX2+/LVDS_B2+ LVDS/eDP I
109 eDP0_TX2-/LVDS_A2- LVDS/eDP I 110 eDP1_TX2-/LVDS_B2- LVDS/eDP I
111 LVDS_PPEN LVDS/eDP I 112 LVDS_BLEN LVDS/eDP I
113 eDP0_TX3+/LVDS_A3+ LVDS/eDP I 114 eDP1_TX3+/LVDS_B3+ LVDS/eDP I
115 eDP0_TX3-/LVDS_A3- LVDS/eDP I 116 eDP1_TX3-/LVDS_B3- LVDS/eDP I
117 GND PWR 118 GND PWR
119 eDP0_AUX+/LVDS_A_CLK+ LVDS I 120 eDP1_AUX+/LVDS_B_CLK+ LVDS IO
121 eDP0_AUX-/LVDS_A_CLK- LVDS I 122 eDP1_AUX-/LVDS_B_CLK- LVDS IO
123 LVDS_BLT_CTRL/ GP_PWM_OUT0 LVDS/eDP I 124 GP_1-Wire_Bus/ HDMI_CEC (RSVD) HDMI/DP IO
125 LVDS_DID_DAT/GP_I2C_DAT LVDS IO 126 eDP0_HPD#/LVDS_BLC_DAT LVDS IO
127 LVDS_DID_CLK/GP_I2C_CLK LVDS IO 128 eDP1_HPD#/LVDS_BLC_CLK LVDS IO
129 CAN0_TX CAN I 130 CAN0_RX CAN O
131 DP_LANE3+/TMDS_CLK+ (SDVO_BCLK+) HDMI/DP I 132 USB_SSTX1- (SDVO_INT+) USB I
133 DP_LANE3-/TMDS_CLK- (SDVO_BCLK-) HDMI/DP I 134 USB_SSTX1+ (SDVO_INT-) I
135 GND PWR 136 GND PWR
137 DP_LANE1+/TMDS_LANE1+ (SDVO_GREEN+) HDMI/DP I 138 DP_AUX+ (SDVO_FLDSTALL+) DP IO NC
139 DP_LANE1-/TMDS_LANE1- (SDVO_GREEN-) HDMI/DP I 140 DP_AUX- (SDVO_FLDSTALL-) DP IO NC
141 GND PWR 142 GND PWR
143 DP_LANE2+/TMDS_LANE0+ (SDVO_BLUE+) HDMI/DP I 144 USB_SSRX1- (SDVO_TVCLKIN+) USB O
145 DP_LANE2-/TMDS_LANE0- (SDVO_BLUE-) HDMI/DP I 146 USB_SSRX1+ (SDVO_TVCLKIN-) USB O
147 GND PWR 148 GND PWR
149 DP_LANE0+/TMDS_LANE2+ (SDVO_RED+) HDMI/DP I 150 HDMI_CTRL_DAT (SDVO_CTRL_DAT) HDMI/DP IO
151 DP_LANE0-/TMDS_LANE2- (SDVO_RED-) HDMI/DP I 152 HDMI_CTRL_CLK (SDVO_CTRL_CLK) HDMI/DP IO
153 HDMI_HPD# HDMI/DP O PU 154 DP_HPD# DP O NC
155 PCIE_CLK_REF+ PCI-E I 156 PCIE_WAKE# PCI-E O
157 PCIE_CLK_REF- PCI-E I 158 PCIE_RST# PCI-E I
159 GND PWR 160 GND PWR
161 PCIE3_TX+ PCI-E I NC 162 PCIE3_RX+ PCI-E O NC
163 PCIE3_TX- PCI-E I NC 164 PCIE3_RX- PCI-E O NC
165 GND PWR 166 GND PWR
167 PCIE2_TX+ PCI-E I NC 168 PCIE2_RX+ PCI-E O NC
169 PCIE2_TX- PCI-E I NC 170 PCIE2_RX- PCI-E O NC
171 UART0_TX (EXCD0_PERST#) UART I 172 UART0_RTS# (EXCD1_PERST#) UART I
173 PCIE1_TX+ PCI-E I 174 PCIE1_RX+ PCI-E O
175 PCIE1_TX- PCI-E I 176 PCIE1_RX- PCI-E O
177 UART0_RX (EXCD0_CPPE#) UART O 178 UART0_CTS# (EXCD1_CPPE#) UART O
179 PCIE0_TX+ PCI-E I 180 PCIE0_RX+ PCI-E O
181 PCIE0_TX- PCI-E I 182 PCIE0_RX- PCI-E O
183 GND PWR 184 GND PWR
185 LPC_AD0/GPIO0 LPC IO 186 LPC_AD1/GPIO1 LPC IO
187 LPC_AD2/GPIO2 LPC IO 188 LPC_AD3/GPIO3 LPC IO
189 LPC_CLK/GPIO4 LPC IO 190 LPC_FRAME#/GPIO5 LPC IO
191 SERIRQ/GPIO6 LPC IO 192 LPC_LDRQ#/GPIO7 LPC IO
193 VCC_RTC O 194 SPKR/GP_PWM_OUT2 I
195 FAN_T_IN/GP_TIMER_IN MISC O 196 FAN_OUT/GP_PWM_OUT1 MISC I
197 GND PWR 198 GND PWR
199 SPI_MOSI SPI I 200 SPI_CS0# SPI I
201 SPI_MISO SPI O 202 SPI_CS1# SPI I
203 SPI_SCK SPI I 204 MFG_NC4 O
205 VCC_5V_SB O 206 VCC_5V_SB O
207 MFG_NC0 MFG O 208 MFG_NC2 MFG O
209 MFG_NC1 MFG I 210 MFG_NC3 MFG O
211 NC (VCC) 212 NC (VCC)
213 NC (VCC) 214 NC (VCC)
215 NC (VCC) 216 NC (VCC)
217 NC (VCC) 218 NC (VCC)
219 VCC O 220 VCC O
221 VCC O 222 VCC O
223 VCC O 224 VCC O
225 VCC O 226 VCC O
227 VCC O 228 VCC O
229 VCC O 230 VCC O

PCI Express interface signals

Q7_Base can offer externally four PCI Express lane, which are directly managed by external Q7-module.
PCI express Gen 3.0 (8Gbps) is supported.
Here following the signals involved in PCI express management:

Таблица 5: Q7 PCIe signals
Signal Name Pin(s) Direction Voltage
standard
Description Comments
PCIE0_TX+ 179 in PCI Express lane #0, Transmitting Input Differential pair.
PCIE0_TX- 181
PCIE0_RX+ 180 out PCI Express lane #0, Receiving Output Differential pair.
PCIE0_RX- 182
PCIE1_TX+ 173 in PCI Express lane #1, Transmitting Input Differential pair.
PCIE1_TX- 175
PCIE1_RX+ 174 out PCI Express lane #1, Receiving Output Differential pair.
PCIE1_RX- 176
PCIE2_TX+ 167 in PCI Express lane #2, Transmitting Input Differential pair.
PCIE2_TX- 169
PCIE2_RX+ 168 out PCI Express lane #2, Receiving Output Differential pair.
PCIE2_RX- 170
PCIE3_TX+ 161 in PCI Express lane #3, Transmitting Input Differential pair.
PCIE3_TX- 163
PCIE3_RX+ 162 out PCI Express lane #3, Receiving Output Differential pair.
PCIE3_RX- 164
PCIE_CLK_REF+ 155 in PCI Express Reference Clock for Lanes 0 to 3, Differential Pair.
PCIE_CLK_REF- 157
PCIE_WAKE# 156 out 3V3 Wake-up (output) signal to the system on external Q7-module. It is connected to the Ethernet Controller WGI210ITSLJX_ (U22.16) through 0 Ohm resistor (R70), for the possibility of disconnection.
PCIE_RST# 158 in 3V3 Input Reset Signal that is sent from external Q7-module to the Ethernet Controller (U22.17) and to the connector MDT420M02001 (X1.50).

UART interface signals

Q7-Base offers one UART interface.
Here following the signals related to UART interface:

Таблица 6: Q7 Uart signals
Signal Name Pin(s) Direction Voltage
standard
Description Comments
UART0_TX 171 in 3V3 UART Interface, Serial data Transmit line.
UART0_RX 177 out 3V3 UART Interface, Serial data Receive line.
UART0_RTS# 172 in 3V3 UART Interface, Handshake signal, Request to Send line.
UART0_CTS# 178 out 3V3 UART Interface, Handshake signal, Clear to Send line.

Gigabit Ethernet signals

Here following the signals involved in PCI express management

Таблица 7: Q7 ethernet signals
Signal Name Pin(s) Direction Voltage
standard
Description Comments
GBE_MDI0+ 12 in/out Media Dependent Interface (MDI) I/O differential pair #0. The MDI can operate in 1000, 100, and 10Mbit/sec modes.
This signal pair is used for all modes.
GBE_MDI0- 10
GBE_MDI1+ 11 in/out Media Dependent Interface (MDI) I/O differential pair #1. The MDI can operate in 1000, 100, and 10Mbit/sec modes.
This signal pair is used for all modes.
GBE_MDI1- 9
GBE_MDI2+ 6 in/out Media Dependent Interface (MDI) I/O differential pair #2. The MDI can operate in 1000, 100, and 10Mbit/sec modes. This signal pair is only used for 1000Mbit/sec Gigabit Ethernet mode.
GBE_MDI2- 4
GBE_MDI3+ 5 in/out Media Dependent Interface (MDI) I/O differential pair #3. The MDI can operate in 1000, 100, and 10Mbit/sec modes. This signal pair is only used for 1000Mbit/sec Gigabit Ethernet mode.
GBE_MDI3- 3
GBE_ACT# 14 in 3V3 Ethernet controller activity indicator.
GBE_LINK# 13 in 3V3 Ethernet controller link indicator.
GBE_LINK100# 7 in 3V3 Ethernet controller 100Mbps link indicator. Not used.
GBE_LINK1000# 8 in 3V3 Ethernet controller 1Gbps link indicator. Not used.
GBE_CTREF 15 in Reference voltage for Ethernet channel 0 magnetics center tap.

SATA signals

There are two SATA interface on Q7_Base, but it is available only one.
Here following the signals related to SATA interface:

Таблица 8: Q7 SATA signals
Signal Name Pin(s) Direction Voltage
standard
Description Comments
SATA0_TX+ 29 in Serial ATA Channel #0 Transmit differential pair.
SATA0_TX- 31
SATA0_RX+ 35 out Serial ATA Channel #0 Receive differential pair.
SATA0_RX- 37
SATA_ACT# 33 in 3V3 Serial ATA Activity Led. Not used.
SATA1_TX+ 30 in Serial ATA channel 1, Receive Input differential pair. Not used.
SATA1_TX- 32
SATA1_RX+ 36 out Serial ATA channel 1, Transmit Output differential pair. Not used.
SATA1_RX- 38

SDI/O interface signals

SDI/O port #1 can work in 1-bit and 4-bit.

Signals involved with SDI/O interface are the following:

Таблица 9: Q7 SDIO signals
Signal NamePin(s)DirectionVoltage
standard
Description Comments
SDIO_CD# 43 in/out 3V3 Card Detect Output which signals that a SDIO Card is present.
SDIO_CLK 42 in 3V3 Clock Line.
SDIO_CMD 45 in/out 3V3 Command/Response line. Signal used to send command from Host (Q7 module) to the connected card (Q7_Base), and to send the response from the card to the Host.
SDIO_LED 44 in 3V3 LED input signal. Not used.
SDIO_WP 46 in/out 3V3

10kΩ pull-down
Write Protect bidirectional signal.
SDIO_PWR# 47 in 3V3 SD power enable (It is used to drive an LED when there are transfers on SD Bus). Not used.
SDIO_DAT[0÷7] 48-51 in/out 3V3 SDIO data bus. SDIO_DAT0 signal is used for all communication modes. SDIO_DAT[1÷3] signals are required for 4-bit SDIO communication modes. SDIO_DAT[4÷7] not used.

USB interface signals

Here following the signals related to USB interfaces.

Таблица 10: Q7 USB signals
Signal Name Pin(s) Direction Voltage
standard
Description Alternative Alternative
Description
Comments
USB_P0+ 96 in/out Universal Serial Bus Port #0 differential pair.
USB_P0- 94
USB_P1+ 95 in/out Universal Serial Bus Port #1 differential pair.
USB_P1- 93
USB_P2+ 90 in/out Universal Serial Bus Port #2 differential pair.
USB_P2- 88
USB_P3+ 89 in/out Universal Serial Bus Port #3 differential pair.
USB_P3- 87
USB_P4+ 84 in/out Universal Serial Bus Port #4 differential pair. USB_SSRX2+ USB Super Speed Port #2 receive differential pair. out
USB_P4- 82 USB_SSRX2-
USB_P5+ 83 in/out Universal Serial Bus Port #5 differential pair. USB_SSTX2+ USB Super Speed Port #2 transmit differential pair. in
USB_P5- 81 USB_SSTX2-
USB_P6+ 78 in/out Universal Serial Bus Port #6 differential pair. USB_SSRX0+ USB Super Speed Port #0 receive differential pair. out
USB_P6- 76 USB_SSRX0-
USB_P7+ 77 in/out Universal Serial Bus Port #7 differential pair. USB_SSTX0+ USB Super Speed Port #0 transmit differential pair. in
USB_P7- 75 USB_SSTX0-
USB_SSRX1+ 132 out USB Super Speed Port #1 receive differential pair.
USB_SSRX1- 134
USB_SSTX1+ 144 in USB Super Speed Port #1 transmit differential pair.
USB_SSTX1- 146
USB_0_1_OC# 86 out 3V3 USB Over Current Detect Input. This pin used for overcurrent detection of USB Port#0 and #1.
USB_2_3_OC# 85 out 3V3 USB Over Current Detect Input. This pin has to be used for overcurrent detection of USB Ports #2 and/or #3.
USB_4_5_OC# 80 out 3V3 USB Over Current Detect Input. This pin used for overcurrent detection of USB Port #4 and/or #5.
USB_6_7_OC# 79 out 3V3 USB Over Current Detect Input. This pin used for overcurrent detection of USB Port #6 and/or #7.
USB_VBUS 91 out 3V3 ? USB Client mode Power Input. It is possible to connect 5v
USB_ID 92 out 3V3
10kΩ pull-down
USB ID Input. USB Port #1 has set to work in Host mode.
USB_OTG_PEN 56 In 3V3 USB Power enable pin for USB Port 1. Not used.

CAN interface signals

Signals involved with CAN interface are the following:

Таблица 11: Q7 CAN signals
Signal NamePin(s)DirectionVoltage
standard
Description Comments
CAN0_TX 129 in 3V3 CAN Transmit Input for CAN Bus Channel 0.
CAN0_RX 130 out 3V3 CAN Receive Output for CAN Bus Channel 0.

SPI interface signals

Signals involved with SPI management are the following:

Таблица 12: Q7 SPI signals
Signal Name Pin(s) Direction Voltage
standard
Description Comments
SPI_MOSI 199 in 3V3 SPI Master Out Slave In, output from Q7 module to the SPI devices.
SPI_MISO 201 out 3V3 SPI Master In Slave Out, Input to Q7 module from SPI devices.
SPI_SCK 203 in 3V3 SPI Clock, Output to the SPI devices from Q7 module.
SPI_CS0# 200 in 3V3 SPI primary Chip select.
SPI_CS1# 202 in 3V3 SPI secondary Chip select. This signal used only in case there are two SPI devices connecting to Q7_Base,
and the first chip select signal (SPI_CS0#) has already been used.

LVDS Flat Panel signals

It is available two LVDS channels, each one consisting of 1 clock pair and four data pairs.

It is possible to configure LVDS (in Q7 module) output so that it can be used as: One single channel, Two identical single channel outputs, Two independent single channel outputs.

Here following the signals related to LVDS management:

Таблица 13: Q7 LVDS signals
Signal Name Pin(s) Direction Voltage
standard
Description Alternative Alternative Description Comments
LVDS_A0+ 99 in LVDS Channel #0 differential data pair #0. eDP0_TX0+ eDP channel differential data pair #0.
LVDS_A0- 101 eDP0_TX0-
LVDS_A1+ 103 in LVDS Channel #0 differential data pair #1. eDP0_TX1+ eDP channel differential data pair #1.
LVDS_A1- 105 eDP0_TX1-
LVDS_A2+ 107 in LVDS Channel #0 differential data pair #2. eDP0_TX2+ eDP channel differential data pair #2.
LVDS_A2- 109 eDP0_TX2-
LVDS_A3+ 113 in LVDS Channel #0 differential data pair #3. eDP0_TX3+ eDP channel differential data pair #3.
LVDS_A3- 115 eDP0_TX3-
LVDS_A_CLK+ 119 in LVDS Channel #0 differential Clock. eDP0_AUX+ eDP channel differential auxiliary channel.
LVDS_A_CLK- 121 eDP0_AUX-
LVDS_B0+ 100 in LVDS Channel #1 differential data pair #0. eDP1_TX0+ eDP secondary channel differential pair 0.
LVDS_B0- 102 eDP1_TX0-
LVDS_B1+ 104 in LVDS Channel #1 differential data pair #1. eDP1_TX1+ eDP secondary channel differential pair 1.
LVDS_B1- 106 eDP1_TX1-
LVDS_B2+ 108 in LVDS Channel #1 differential data pair #2. eDP1_TX2+ eDP secondary channel differential pair 2.
LVDS_B2- 110 eDP1_TX2-
LVDS_B3+ 114 in LVDS Channel #1 differential data pair #3. eDP1_TX3+ eDP secondary channel differential pair 3.
LVDS_B3- 116 eDP1_TX3-
LVDS_B_CLK+ 120 in LVDS Channel #1 differential Clock. eDP1_AUX+ eDP secondary auxiliary channel.
LVDS_B_CLK- 122 eDP1_AUX-
LVDS_PPEN 111 in 3V3 Panel Power Enable signal. It can be used to turn On/Off the connected LVDS display.
LVDS_BLEN 112 in 3V3 Panel Backlight Enable signal. It can be used to turn On/Off the backlight’s lamps of connected LVDS display.
LVDS_BLT_CTRL/
GP_PWM_OUT0
123 in 3V3 This signal can be used to adjust the panel backlight brightness in displays supporting Pulse Width Modulated (PWM) regulations.
When backlight brightness control via PWM is not required, this signal can be used as a General Purpose PWM output.
LVDS_BLC_DAT 126 in/out 3V3 I2C control data line for external Spread Spectrum Control Clock chip. eDP0_HPD# eDP primary Hotplug detection.
LVDS_BLC_CLK 128 in/out 3V3 I2C control clock line for external Spread Spectrum Control Clock chip. eDP1_HPD# eDP secondary Hotplug detection.
LVDS_DID_DAT 125 in/out 3V3 DisplayID DDC Data line for LVDS flat Panel detection.
LVDS_DID_CLK 127 in/out 3V3 DisplayID DDC Clock line for LVDS flat Panel detection.

Audio interface signals

The signals related to Audio interface:

Таблица 14: Q7 Audio signals
Signal NamePin(s)DirectionVoltage
standard
Description Comments
HDA_SYNC 59 in 3V3 Serial Bus Synchronization.
HDA_RST# 61 in 3V3 Codec Reset.
HDA_BCLK 63 in 3V3 Serial Bit Clock signal.
HDA_SDO 67 in 3V3 Serial Data Out signal.
HDA_SDI 65 out 3V3 Serial Data In signal.

HDMI interface signals/DP interface signals

By using HDMI interface along with two LVDS single channel interfaces, it is possible to drive up to 3 independent displays.

Signals involved in HDMI management are the following:

Таблица 15: Q7 HDMI signals
Signal Name Pin(s) Direction Voltage
standard
Description Alternative Alternative Description Comments
TMDS_CLK+ 131 in TMDS differential Clock. DP_LANE3+ Display Port differential pair #3.
TMDS_CLK- 133 in DP_LANE3-
TMDS_TX0+ 143 in TMDS differential pair #0. DP_LANE2+ Display Port differential pair #2.
TMDS_TX0- 145 in DP_LANE2-
TMDS_TX1+ 137 in TMDS differential pair #1. DP_LANE1+ Display Port differential pair #1.
TMDS_TX1- 139 in DP_LANE1-
TMDS_TX2+ 149 in TMDS differential pair #2. DP_LANE0+ Display Port differential pair #0.
TMDS_TX2- 151 in DP_LANE0-
HDMI_CTRL_DAT 150 in/out 3V3 DDC Data line for HDMI panel.
HDMI_CTRL_CLK 152 in/out 3V3 DDC Clock line for HDMI panel.
HDMI_HPD# 153 out 3V3 Hot Plug Detect Output signal.
HDMI_CEC 124 in/out 3V3 HDMI Consumer Electronics Control (CEC) Line.
DP_AUX+ Display Port auxiliary channel differential pair. in/out pin 138
DP_AUX- in/out pin 140
DP_HPD# DisplayPort Hot Plug Detect output signal. 3V3 level out pin 154 not used.

LPC/GPIO interface signals

The Low Pin Count (LPC) bus interface is a cost-efficient, low-speed interface designed to support low-speed legacy devices such as a Super I/O controller or a firmware hub device.

There are 8 pins that can be used for implementation of Low Pin Count (LPC) Bus interface or as General Purpose I/Os (GPIO).

When the Q7 module is programmed for LPC Interface, following signals will be available:

Таблица 16: Q7 LPC/GPIO signals
Signal NamePin(s)DirectionVoltage
standard
Description Comments
LPC_AD[0÷3] 185-188 in/out 3V3 LPC data bus, bidirectional signal. in/out signals GPIO0-GPIO3
LPC_CLK 189 in 3V3 LPC Clock Input line. in/out signal GPIO4
LPC_FRAME# 190 in 3V3 LPC Frame indicator. This signal is used to signal the start of a new cycle of transmission, or the termination of existing cycles due to abort or time-out condition.in/out signal GPIO5
LPC_LDRQ# 192 out 3V3 LPC DMA request. This signal is used only by peripherals requiring DMA or bus mastering. in/out signals GPIO7
SERIRQ 191 in/out 3V3 LPC Serialised IRQ request, bidirectional line. This signal is used only by peripherals requiring Interrupt support. in/out signals GPIO6

When the Q7 module is programmed for GPIOs, all previous signals are not available and corresponding pins on Qseven connector are General Purpose I/Os, bidirectional signals at +3.3V electrical level.

I2C interface signals

Signals involved with I2C interface are the following:

Таблица 17: Q7 I2C signals
Signal NamePin(s)DirectionVoltage
standard
Description Comments
SMB_CLK 60 in/out 3V3

4k7Ω pull-up
SM Bus control clock line for System Management.
SMB_DAT 62 in/out 3V3

4k7Ω pull-up
SM Bus control data line for System Management.
SMB_ALERT# 64 in/out 3V3

4k7Ω pull-up
SM Bus Alert line for System Management.
GP0_I2C_CLK 66 in/out 3V3 General purpose I2C Bus clock line.
GP0_I2C_DAT 68 in/out 3V3 General purpose I2C Bus data line.

Power Management signals

There is a set of signals that are used to manage the power rails and power states.

The signals involved are:

Таблица 18: Q7 power signals
Signal NamePin(s)DirectionVoltage
standard
Description Comments
PWGIN 26 out 5V Power Good. This signal signals that power supply section is ready and stable.
PWRBTN# 20 out 3V3

10kΩ pull-up
Power Button. This signal connected to a push-button SW1: a pulse to GND of this signal switch power supply On or Off.
RSTBTN# 28 out 3V3

10kΩ pull-up
Reset Button. This signal connected to a push-button SW2: a pulse to GND of this signal reset the Q7 module.
BATLOW# 27 out 3V3

10kΩ pull-up
Battery Low. Not used.
WAKE# 17 out 3V3

10kΩ pull-up
Wake Output. Not used.
SUS_STAT# 19 in 3V3 Suspend status. This input connected to X14.
SUS_S3# 18 in 3V3 S3 status input. Not used.
SUS_S5# 16 in 3V3 S5 State input: This signal indicates S4 or S5 (Soft Off) state. Not used.
SLP_BTN# 21 out 3V3

10kΩ pull-up
Sleep button. Not used.
LID_BTN# 22 out 3V3

10kΩ pull-up
LID button. Not used.

Fan Control Implementation

Таблица 19: Q7 fan control
Signal NamePin(s)DirectionVoltage
standard
Description Comments
FAN_T_IN 195 out 3V3 Fan tachometer input (can be used as General Purpose Timer Input).
FAN_OUT 196 in 3V3 Fan speed control (can be used as General Purpose PWM Output).

Thermal Management Signals

Таблица 20: Q7 thermal management signals
Signal NamePin(s)DirectionVoltage
standard
Description Comments
THRM# 69 out 3V3 Thermal Alarm Input to indicate an over temperature situation (can be used to initiate thermal throttling).
THRMTRIP# 71 in 3V3 This signal used to communicate Q7_Base devices. Thermal Trip indicates an overheating condition of the processor.

Miscellaneous signals

Таблица 21: Q7 miscellaneous signals
Signal NamePin(s)DirectionVoltage
standard
Description Comments
WDTRIG# 70 out 3V3 Watchdog Trigger Signal.
WDOUT 72 in 3V3 Watchdog event indicator.
SPKR 194 in 3V3 Speaker output.
BIOS_DIS# 41 out 3V3 Module BIOS disable input signal.

Manufacturing signals

This pins are reserved for manufacturing and debugging purposes.

Таблица 22: Q7 manufacturing signals
Signal NamePin(s)DirectionVoltage
standard
Description Comments
MFG_NC0 207 out 3V3 JTAG_TCK / specific control signal May be used as JTAG_TCK signal for boundary scan purposes during production or as a vendor specific control signal.
MFG_NC1 209 in 3V3 JTAG_TDO / UART_TX May be used as JTAG_TDO signal for boundary scan purposes during production. May also be used, via a multiplexer, as a UART_TX signal to connect a simple UART for firmware and boot loader implementations.
MFG_NC2 208 out 3V3 JTAG_TDI / UART_RX May be used as JTAG_TDI signal for boundary scan purposes during production. May also be used, via a multiplexer, as a UART_RX signal to connect a simple UART for firmware and boot loader implementations.
MFG_NC3 210 out 3V3 JTAG_TMS / BOOT May be used as JTAG_TMS signal for boundary scan purposes during production. May also be used, via a multiplexer, as vendor specific BOOT signal for firmware and boot loader implementations.
MFG_NC4 204 out 3V3

10kΩ pull-down
JTAG-TRST / control signal for a multiplexer circuitMay be used as JTAG_TRST# signal for boundary scan purposes during production. May also be used as control signal for a multiplexer circuit on the module enabling secondary function for MFG_NC0..3 ( JTAG / UART ). Can use 10kΩ pull-up resistor.

GND signals

Таблица 23: Q7 GND
Pin(s) Description Comments
1, 2, 23, 24, 25,
34, 39, 40, 57, 58,
73, 74, 97, 98, 117,
118, 135, 136, 141,
142, 147, 148, 159,
160, 165, 166, 183,
184, 197, 198
GND Ground

Power signals

Таблица 24: Q7 power
Signal NamePin(s) Voltage
standard
Description Comments
VCC 219-230 5V Power Supply +5V .
VCC_5V_SB 205,

206
5V Standby Power Supply +5V.
VCC_RTC 193 3V +3V Real Time Clock (RTC) supply voltage (3V backup cell input. Used for RTC operation and storage register non-volatility in the absence of system power).

NC and reserved signals

Таблица 25: Q7 NC and reserved signals
Signal Name Pin(s)Voltage
standard
DescriptionComments
reserved (SDIO_LED) 44 SDIO_LED
reserved (SDIO_DAT5)52 SDIO_DAT[4…7]
reserved (SDIO_DAT4)53
reserved (SDIO_DAT7)54
reserved (SDIO_DAT6)55
NC (VCC) 211-218 These pins reserved for use in later Qseven® revisions to avoid backward compatibility issues in the future.

SPI

The Q7_Base provides connection to the Serial Peripheral Interface (SPI) Bus via connector X13, SPI signals are connected to Q7 connector.

The 10 pin socket can be used for connection for external interface - SPI EEPROM and Serial Flash devices. For example, you can a 3.3V serial flash in the socket to boot the system from external BIOS.

Таблица 26: SPI Connector
Function SPI Connector
Location X13
P/N PLD-10
Pinout Pin Description
1 SPI_MOSI
2 GND
3 SPI_MISO
4 GND
5 SPI_SCK
6 GND
7 SPI_CS1
8 GND
9 SPI_CS0
10 GND

I2C

Three I2C interfaces is available on Q7_Base: 2x I2C Q7_module to Q7_Base, 1x I2C MCU (STM8) Q7_Base control (see MCU).



Рисунок 6: I2C Q7Base

Таблица 27: I2C Connector
Function I2C Connector
Location X11
P/N PLD-10
Pinout Pin Description
1 I2C1_SMB_SCL
2 GND
3 I2C1_SMB_SDA
4 GND
5 SMB_ALERT#
6 GND
7 I2C0_SCL
8 GND
9 I2C0_SDA
10 GND

LPC

To support LPC and GPIO devices, the LPC and GPIO signals are shared on the Q7_Base from Q7 module. The shared signals are connected to pin header X12.

This header can be used for debugging or to connect devices such as Super I/O for evaluation.

Таблица 28: LPC/GPIO Connector
Function LPC/GPIO Connector
Location X12
P/N PLD-10
Pinout Pin Description
1 LPC_GPIOX8_LDRQ#
2 LPC_GPIOX8_AD1
3 LPC_GPIOX8_AD3
4 LPC_GPIOX8_AD0
5 LPC_GPIOX8_FRAME#
6 GND
7 LPC_GPIOX8_AD2
8 LPC_GPIOX8_CLK
9 LPC_GPIOX8_SERIRQ
10 GND

HDMI

HDMI signals are shared on the Q7_Base devices (using connector X20) from Q7 module (X4).

For high-speed electrostatic discharge (ESD) transient voltage suppression (TVS) is used High Definition Multimedia Interface (HDMI) device TPD12S016 with auto-direction sensing I2C voltage level shift buffers, with integrated protection diodes, with current limited 5-V output HDMI power line and with reverse current blocking when the system is powered off.



Рисунок 7: HDMI Q7Base

Таблица 29: HDMI Connector
Function HDMI Connector
Location X20
P/N 10029449-111RLF Amphenol
Pinout Pin Description Pin Description
1 DP_D0_P (D2+) 11 GND
2 GND 12 DP_D3_N (CLK-)
3 DP_D0_N (D2-) 13 CEC_B_X
4 DP_D1_P (D1+) 14 NC
5 GND 15 HDMI_SCL_X
6 DP_D1_N (D1-) 16 HDMI_SDA_X
7 DP_D2_P (D0+) 17 GND
8 GND 18 5V_HDMI_X
9 DP_D2_N (D0-) 19 HPD_B_X
10 DP_D3_P (CLK+)

LVDS

This connector provides data and power connection between the Q7_Base and the Display.

The Q7_Base supports two LVDS panels can be used at the same time.
The Q7_Base has two LVDS ports, A and B, which can either be used for one panel with up to 165 Mpixel/s or as two separate ports up to 85 Mpixel/s. In either configuration, the Qseven specification only provides one set of backlight and panel power enable signals as well as one brightness control signal for both of them.

The panel can be enabled with he LVDS_PPEN signal and the backlight can be switched on with LVDS_BLEN.

One LVDS Panel

Connection one display to port A. LVDS_B signals are not used.

One LVDS Panel with a higher resolution

In this option connection LVDS_A and LVDS_B signals to the connector X19.

Two LVDS Panel

Connection two LVDS panels. Panel 1 – the primary one – is connected to port A with its corresponding panel power enable signal and the associated backlight enable signal.

This connector provides data and power connection between the Q7_Base and the Display.

Таблица 30: LVDS Connector
Function LVDS Connector
Location X19
P/N B34B-PHDSS_ JST Sales America Inc.
Pinout Pins Name Pins Name
1 LVDS_DID_SCL 18 LVDS_BLT_CTRL
2 LVDS_DID_SDA 19 GND
3 3V3 20 LVDS_A_D3_N
4 3V3 21 LVDS_B_D0_P
5 LVDS_A_D0_N 22 LVDS_B_D0_N
6 GND 23 LVDS_B_D1_N
7 LVDS_PPEN 24 GND
8 LVDS_A_D0_P 25 GND
9 LVDS_A_D1_P 26 LVDS_B_D1_P
10 LVDS_A_D1_N 27 LVDS_B_D2_P
11 LVDS_A_D2_P 28 LVDS_B_D2_N
12 LVDS_BLEN 29 LVDS_B_CLK_P
13 eDP0_HPD 30 GND
14 LVDS_A_D2_N 31 eDP1_HPD
15 LVDS_A_CLK_P 32 LVDS_B_CLK_N
16 LVDS_A_CLK_N 33 LVDS_B_D3_N
17 LVDS_A_D3_P 34 LVDS_B_D3_P

LVDS power and control

Connector X24 on Q7_Base is a 5-pin header designated for backlight voltage. Supply voltage for the backlight converter can be set to +12V or +5V.

Таблица 31: LVDS Controls panel
Function LVDS Controls panel
Location X24
P/N B5B-PH-K-S_
Pinout Pin Description
1 12VINT
2 GND
3 LVDS_BLEN
4 LVDS_BLT_CTRL
5 5V

Fuses F1 (12VINT) and F2 (5V) are additionally installed on the power circuit.

USB

Four USB interfaces is available on Q7_Base: 3xUSB 3.0, 1xUSB 2.0.

USB port #0, #1, #2, along with the Superspeed USB port #0, #1, #2, are carried to a standard USB 3.0 Type A receptacle.

USB port #3 are carried out to standard USB 2.0 Type A receptacles.

Debug console (USB to UART bridge) are carried out to standard USB 2.0 Type B receptacles.

For EMI/ESD protection and overcurrent protection, USB Switch, TVS and ESD Diodes are used on USB data and voltage lines.

USB Port 0

Таблица 32: USB Port 0 Connector
Function USB Port 0 Connector
Location X15
P/N 10132411-00021LF AMPHENOL
Pinout Pin Description
1 5V0_P0 (VBUS)
2 USB0_X_N (D-)
3 USB0_X_P (D+)
4 GND
5 USB6_SSRX0_N (STDA_SSRX-)
6 USB6_SSRX0_P (STDA_SSRX+)
7 GND
8 USB7_SSTX0_N (STDA_SSTX-)
9 USB7_SSTX0_P (STDA_SSTX+)

USB Port 1

Таблица 33: USB Port 1 Connector
Function USB Port 1 Connector
Location X16
P/N 10132411-00021LF AMPHENOL
Pinout Pin Description
1 5V0_P1 (VBUS)
2 USB2_X_N (D-)
3 USB2_X_P (D+)
4 GND
5 USB4_SSRX2_N (STDA_SSRX-)
6 USB4_SSRX2_P (STDA_SSRX+)
7 GND
8 USB5_SSTX2_N (STDA_SSTX-)
9 USB5_SSTX2_P (STDA_SSTX+)

USB Port 2

Таблица 34: USB Port 2 Connector
Function USB Port 2 Connector
Location X17
P/N 10132411-00021LF AMPHENOL
Pinout Pin Description
1 5V0_P2 (VBUS)
2 USB1_X_N (D-)
3 USB1_X_P (D+)
4 GND
5 USB_SSRX1_N (STDA_SSRX-)
6 USB_SSRX1_P (STDA_SSRX+)
7 GND
8 USB_SSTX1_N (STDA_SSTX-)
9 USB_SSTX1_P (STDA_SSTX+)

USB Port 3

USB Host 3 signals from the Q7 connector is connected to standard USB Type-A connector.

Таблица 35: USB Port 3 Connector
Function USB Port 3 Connector
Location X18
P/N 292303-1 TECONN
Pinout Pin Description
1 5V0_P3 (VCC)
2 USB3_X_N (DM)
3 USB3_X_P (DP)
4 G
G GND

Debug console (USB to UART bridge)

For converting UART to USB used a USB-to-Dual-UART Bridge Controller CP2105 (U2). The CP2105 includes a USB 2.0 fullspeed function controller, USB transceiver, oscillator, one-time programmable ROM, and two asynchronous serial data buses (UART) with full modem control signals.
For asynchronous communication between two data buses is used dual-bit noninverting bus transceiver with two separate configurable power-supply rails the SN74AVC (U3).



Рисунок 8: Q7Base USB debug console

Таблица 36: USB Connector (USB to UART console)
Function USB (USB to UART console) Connector
Location X8
P/N 1734035-1 TECONN
Pinout Pin Description
1 VCC
2 DM
3 DP
4 ID
5 GND

Serial



Рисунок 9: Q7Base serial diagram

For connection to standard serial ports (like those offered by common PCs, for example) it is include RS-232 transceiver ST3232EB_ (U25) and RS-485 transceiver ADM3491EAR_ (U24) on the board.

Jumpers for RS-232\RS485\RS422 selection

Таблица 37: Jumpers for RS-232\RS485\RS422 selection
X24 X25 X26 X27 X28 X29 X30 X31 X32 X33 X38 X39
RS232 - + - + - + - + - + - -
RS422 + - + - + - + - + - - -
RS485 + - + - + - + - + - + +

where “+“ means Populated, “- “ - Not Populated

RS-232

Таблица 38: RS232 Data Connection
Function RS232 Data Connection
Location X36
P/N 15EDGRC-3.5-03 DEGSON
Pinout Pin Description
1 RX
2 TX
3 GND
Таблица 39: RS232 detect Connection
Function RS232 detect Connection
Location X37
P/N 15EDGRC-3.5-03 DEGSON
Pinout Pin Description
1 CTS
2 RTS
3 GND

RS-485\RS-422

Jumpers for RS-485\RS422 selection and options

Optional jumpers - Using termination resistors

To suppress reflection at the end of the line, it is recommended to add termination resistors between signal pairs at both ends of the cable.
The Q7_Base have on board termination resistors that can be enabled through jumpers, so if a device is placed at one of the ends of the cable place jumpers on required position.

Таблица 40: Optional jumpers - Using termination resistors
X34 X35
Adding termination resistors to the linePopulated Populated
No termination resistors to the line Not PopulatedNot Populated

When adding termination to the line, no more than two resistors should be used, one at each end of the line.

Optional jumper - Selection control method for receiver and driver
Таблица 41: Optional jumper-for Selection control method for receiver and driver
X49 RS422/RS485 mode
Populated Using external signal DE to control Driver/Receiver ADM3491 on Q7_Base.
Not PopulatedUsing external signal DE to control Driver ADM3491 and signal RE_N to control Receiver ADM3491 on Q7_Base.
Таблица 42: RS485 data1 Connection
Function RS485 data1 Connection
Location X40
P/N 15EDGRC-3.5-03 DEGSON
Pinout Pin Description
1 A
2 B
3 GND
Таблица 43: RS485 data2 Connection
Function RS485 data2 Connection
Location X41
P/N 15EDGRC-3.5-03 DEGSON
Pinout Pin Description
1 Z
2 Y
3 GND

CAN



Рисунок 10: Q7Base CAN diagram

CAN port 0

To connect Qseven CAN interface (Q7 module) to CAN Bus on Q7_Base, it is integrate a CAN Bus Transceiver TJA1051T/3,118 (NXP ) on the board.

Таблица 44: CAN Connector port 0
Function CAN Connector port 0
Location X23
P/N 15EDGRC-3.5-03 DEGSON
Pinout Pin Description
1 CANH_0
2 GND
3 CANL_0

CAN Bus connection is made through a pluggable terminal block (15EDGRC-3.5-03 Degson). 120Ω resistor is placed for line termination, in case that the system is placed to one of the two extremities of CAN Line. Jumper X22 enables or disables CAN bus termination.

CAN port 1

To connect Qseven module to CAN Bus on Q7_Base, it is integrate a CAN Controller MCP2515-I/ML (MICROCHIP) (use SPI interface) and Bus Transceiver TJA1051T/3,118 (NXP ) on the board.

Таблица 45: CAN Connector port 1
Function CAN Connector port 1

Location X48
P/N 15EDGRC-3.5-03 DEGSON
Pinout Pin Description
1 CANH_1
2 GND
3 CANL_1

CAN Bus connection is made through a pluggable terminal block (15EDGRC-3.5-03 Degson). 120Ω resistor is placed for line termination, in case that the system is placed to one of the two extremities of CAN Line. Jumper X7 enables or disables CAN bus termination.

Jumper for options

Таблица 46: CAN optional jumper
Jumper PositionConfiguration
Populated There are no more devices on the line. Used terminating resistor 120Ω at the end of the bus.
Not populated There are other devices or terminating resistor on the line.

Jumper for options

Таблица 47: Optional jumper-CAN terminating resistor
Jumper PositionConfiguration
Populated There are no more devices on the line. Used terminating resistor 120Ω at the end of the bus.
Not populated There are other devices or terminating resistor on the line.

Audio

Q7_Base provides one Inter-IC Sound(I2S) interface, through audio CODEC IC SGTL5000 with I2S interface.

From the codec, 1 microphone input or Line in (MP3/FM) Input, 1 headphone output or Line out (Speaker Amp/Docking Station/FMTX) are available.

The board provides two jack audio connectors for input and output.

5 jumpers are used to switch alternative inputs and outputs.

Таблица 48: 3 position jumpers view
Position Jumpers view
1-2
2-3



Рисунок 11: Q7Base audio diagram

Jumpers for Line selection and options

Таблица 49: Jumpers for Line selection and options
Jumpers LINE_IN MIC
X42 1-2 2-3
X43 1-2 2-3
Jumpers LINE_OUT HP
X44 1-2 2-3
X45 1-2 2-3
X46 1-2 2-3

Ethernet

The Q7_Base is equipped with a RJ45 connector with integrated magnetics to support Gigabit Ethernet on the X9, X10 connectors. Additionally, LED indicators are integrated within the LAN connectors.

Ethernet port 1

Таблица 50: Ethernet port 1
Function Gigabit Ethernet Connector
Location X9
P/N TRJG16464ADNL TRXCOM
Pinout Pin Description
1 GBE0_MDI0_P
2 GBE0_MDI0_N
3 GBE0_MDI1_P
4 GBE0_MDI2_P
5 GBE0_MDI2_N
6 GBE0_MDI1_N
7 GBE0_MDI3_P
8 GBE0_MDI3_N
Таблица 51: Ethernet led
Action Description
LED 1 Yellow litEthernet controller 0 link indicator, directly connected to the Q7 module.
LED 2 Green lit Ethernet controller 0 activity indicator, directly connected to the Q7 module.

Ethernet port 2



Рисунок 12: Q7Base ethernet diagram

The PCIe v2.1 (2.5GT/s) Interface is used by the WGI210ITSLJX as a host interface. The interface only supports the PCIe v2.1 (2.5GT/s) rate and is configured to x1. For communication between Controller on Q7 module and the WGI210 used SMBus interface (see paragraph I2C for more details).

The WGI210 use an external SPI serial interface to a Flash W25Q16JVZPIQ (U21) for storing product configuration information and a boot ROM device.

The WGI210 uses a 100 MHz differential reference clock. This signal is generated on U23 (SI53152-A01AGM_) and routed to U22 (WGI210ITSLJX) .

The WGI210 implements three output drivers used for driving external LED circuits on X10 connector.

Таблица 52: Ethernet port 2
Function Gigabit Ethernet Connector
Location X10
P/N TRJG16464ADNL TRXCOM
Pinout Pin Description
1 GBE1_MDI0_P
2 GBE1_MDI0_N
3 GBE0_MDI1_P
4 GBE1_MDI2_P
5 GBE1_MDI2_N
6 GBE1_MDI1_N
7 GBE1_MDI3_P
8 GBE1_MDI3_N

M.2 PCIe

The Q_Base is equipped with a PCI Express Mini Card socket, connector provide the ability to insert different removable PCI Express Mini Cards. The PCI Express Mini Card utilizes PCI Express link 0.

Таблица 53: PCIE Slot
Function PCIE Slot

Location X1
P/N MDT420M02001 AMPHENOL
Pinout Pin Description Pin Description
1 GND 36 NC
2 3V3_SSD_SATA 37 NC
3 GND 38 DEV_SLEEP_DATA
4 3V3_SSD_SATA 39 GND
5 NC 40 NC
6 NC 41 SATA_B_P
7 NC 42 NC
8 NC 43 SATA_B_N
9 GND 44 NC
10 M2_LED_SATA 45 GND
11 NC 46 NC
12 3V3_SSD_SATA 47 SATA_A_N
13 NC 48 NC
14 3V3_SSD_SATA 49 SATA_A_P
15 GND 50 NC
16 3V3_SSD_SATA 51 GND
17 NC 52 NC
18 3V3_SSD_SATA 53 NC
19 NC 54 NC
20 NC 55 NC
21 GND 56 NC
22 NC 57 GND
23 NC 58 NC
24 NC 67 NC
25 NC 68 NC
26 NC 69 PEDET_SATA
27 GND 70 3V3_SSD_SATA
28 NC 71 GND
29 NC 72 3V3_SSD_SATA
30 NC 73 GND
31 NC 74 3V3_SSD_SATA
32 NC 75 GND
33 GND 76 S (GND)
34 NC 77 S (GND)
35 NC

M.2 SATA

Таблица 54: SATA Slot
Function SATA Slot

Location X2
P/N MDT420M02001 AMPHENOL
Pinout Pin Description Pin Description
1 GND 36 NC
2 3V3_SSD_PCIE 37 NC
3 GND 38 DEV_SLEEP_PCIE
4 3V3_SSD_PCIE 39 GND
5 NC 40 NC
6 NC 41 SATA_B_P
7 NC 42 NC
8 NC 43 SATA_B_N
9 GND 44 NC
10 M2_LED_PCIE 45 GND
11 NC 46 NC
12 3V3_SSD_PCIE 47 SATA_A_N
13 NC 48 NC
14 3V3_SSD_PCIE 49 SATA_A_P
15 GND 50 PERST#
16 3V3_SSD_PCIE 51 GND
17 NC 52 NC
18 3V3_SSD_PCIE 53 NC
19 NC 54 NC
20 NC 55 NC
21 GND 56 NC
22 NC 57 GND
23 NC 58 NC
24 NC 67 NC
25 NC 68 NC
26 NC 69 PEDET_PCIE
27 GND 70 3V3_SSD_PCIE
28 NC 71 GND
29 NC 72 3V3_SSD_PCIE
30 NC 73 GND
31 NC 74 3V3_SSD_PCIE
32 NC 75 GND
33 GND 76 S (GND)
34 NC 77 S (GND)
35 NC

SD Card

The Q7_Base provides one SD/MMC socket (X3).

The SD Card slot can be configured as SD or MMC card operation. The SD Card Slot can support SDIO cards designed to fit in a standard SD card slot. The main power for the Card Socket is 3.3V.

Таблица 55: SD Card Socket
Function SD Card Socket
Location X3
P/N DM3AT-SF-PEJM5 HIROSE
Pinout Pin Description
1 DAT2
2 CD/DAT3
3 CMD
4 VDD
5 CLK
6 VSS
7 DAT0
8 DAT1
9 CD_A
10 CD_B



Рисунок 13: Q7Base sdio diagram

Feature Connector

Таблица 56: Feature Connector
Function Feature Connector
Location X14
P/N DM3AT-SF-PEJM5 HIROSE
Pinout Pin Description
1 3V3
2 GND
3 FAN_T_IN
4 GND
5 GPO0(SUS_STAT#)
6 GND
7 FAN_OUT/GP_PWM_OUT1
8 GND
9 SPKR/GP_PWM_OUT2
10 GND

Fan Connector


The Q7_Base provides the ability to connect 3.3V cooling fans for the CPU module and system.
Connector X14 is for 4pin fan. The FAN_TACHOIN signal originates from the Q7 module.

Debugging/development connectors

Connectors are provided for debugging/development purpose.

JTAG/UART

Q7_Base provides a USB Connector (UART) and JTAG connector for debugging. Both debug interfaces are sharing same signals from Q7 connector, since MFG_NCN4_MUX select line is used to select either UART or JTAG.
Q7_Base provided jumper X25 to select Debug ports. In default jumper will be on UART. A 10-pin JTAG connector is provided on the Q7_Base.

Таблица 57: JTAG Connector
Function JTAG
Location X7
P/N PLD-10
Pinout Pin Description Pin Description
1 JTAG_TCK 6 NC
2 GND 7 NC
3 JTAG_TDO/UART_TX 8 NC
4 3V3 9 JTAG_TDI/UART_RX
5 JTAG_TMS/BOOT 10 GND

UART will be used for Debug purpose. This is not the full functional UART and supports only Serial TX and RX signals.

X25 (JTAG/UART selector)
Таблица 58: JTAG/UART selection jumper
Jumper PositionConfiguration
Populated Selecting UART for debugging.
Not populated Selecting JTAG for debugging.

MCU programming

Connector X21 allows a debugging or programming tool to be connected to the MCU STM8 (U18).

Таблица 59: Program/debug MCU connector
Function Program/debug MCU
Location X21
P/N WF-4 TAB
Pinout Pin Description
1 3V3_WD
2 SWIM
3 GND
4 NRST

Jumpers and Buttons

Jumpers

You can configure board to match the needs of your application by setting jumpers.

Рисунок 14: Q7Base jumpers view

X6 (Module/Carrier BIOS selector)

This signal used to disable standard boot firmware flash device and enable an alternative boot firmware source, for example a boot loader.

Таблица 60: Module/Carrier BIOS selector
Jumper PositionConfiguration
Populated Disabling the integrated Bios module on Q7 module ( BIOS from Q7_Base).
Not populated Enabling the integrated Bios module on Q7 module ( BIOS from CPU Q7 Module Q7 ).

Buttons

Power Button SW1

The Q7_Base performs a power up sequence when you press this button. The power button is connected to the Q7 module’s PWRBTN# signal.

Reset Button SW2

When you press this button, the Q7 module and all components connected on board will perform a hard reset. The reset button is connected to the Q7 module’s RSTBTN# signal.

On-board Devices

3V_battery

The recharge lithium smd battery supplies power to the RTC and memory of the Q7 module. The battery provide 3V of power. It is possible to disconnect battery by unsoldering the resistor R100 (0 Ohm).

Таблица 61: 3V_battery
Function Power VRTC
Location B1
P/N ML-1220/F1AN PANASONIC
Pinout Pin Description
1 GND
2 BAT_OUT

MCU

The 8-bit microcontroller STM8S (U18) with 64 Kbytes Flash program memory is designed for detect the occurrence of fault, generated by external interference and used to resolve processor malfunctions due to hardware or software failures (watchdog).

The microcontroller uses the I2C bus to communicate the temperature sensor TMP102 (U19) and DCDC TPS53819 (U27).



Рисунок 15: Q7Base MCU connections

The single wire interface module (SWIM) permits non-intrusive, real-time incircuit debugging and fast memory programming.

Temperature Sensor

The TMP102 (U19) is a digital temperature sensor with SMBus alert function from Texas Instruments. TMP102 uses the I2C bus to communicate the temperature on STM8 (U18) and runs from 3.3V. The TMP102 is capable of reading temperatures to a resolution of 0.0625°C (on-chip 12-bit ADC), and is accurate up to 0.5°C.
The default address is 0x49 (1001001).

PCIe clock buffer

The Si53152 (U23) is a spread spectrum tolerant PCIe clock buffer that source two PCIe (CLK0 and CLK1) clocks simultaneously. The device has two hardware output enable inputs (CLK_EN0, CLK_EN1) for enabling the respective differential outputs on the fly. The device also features output enable control through I2C communication (Q7 module).



Рисунок 16: Q7Base PCIe clock buffer

GPIO expander

TCA6424A (U33) is 24-bit I/O expander for the two-line bidirectional bus (I2C) is designed to provide remote I/O expansion via the I2C interface.
The default address is 0100011.

Status Information

LEDs

There are three green LEDs D1-D3 (LNJ347W83RA PANASONIC) on the Q7_Base.

Рисунок 17: Q7Base led view

D1

This is programmable MCU user LED.

D2

Led D2 indicates that all power rails located on the board are ready for use.

D3

User led D3 connects to custom signal and used as GPIO.




boards/nms-q7-evm/v1.1_en/start.txt · Последнее изменение: — Roman Abakumov
